Export Packing and Container Loading Documents for Bolted Tank Projects

How buyers can review packing lists, shipping marks, container loading plans, accessory packages, and receiving documents before bolted tank shipment.

Export Packing and Container Loading Documents for Bolted Tank Projects

Export packing is easy to underestimate in bolted storage tank projects. The tank may be designed correctly and produced on schedule, but the receiving team still needs to identify panels, bolts, sealants, nozzles, ladders, platforms, roof parts, and accessory packages after containers arrive. Clear packing and container loading documents help turn factory production into a practical site installation package.

Why packing documents matter for bolted tanks

A bolted tank is not shipped as one finished structure. It is shipped as many coordinated parts that must arrive together and be found quickly on site. Tank sheets, roof components, hardware, sealant, nozzles, manways, platforms, ladders, handrails, anchor items, and spare parts may be packed in separate pallets or crates. If the packing list is vague, the installation team can lose time sorting materials or checking whether an item is missing.

For international projects, packing documents also support customs, site receiving, inventory control, and communication between the owner, EPC contractor, local installer, and supplier. This is why packing review should be connected with the wider bolted tank project documentation checklist, not treated as a minor logistics detail.

Start with a clear packing list

A useful packing list should identify each package, package number, item description, quantity, gross weight, net weight where applicable, dimensions, and any special handling note. For tank panels, buyers should understand whether panel marks connect with drawing references or shell course information. For accessories, the list should separate bolts, nuts, washers, sealants, nozzles, ladder parts, platform parts, roof parts, and small components that may be easy to overlook.

When a project includes several tanks or many accessories, the packing list should make the relationship between each package and each tank clear. This helps the receiving team avoid mixing parts from different tanks or different installation stages.

Shipping marks and package labels

Shipping marks are practical communication tools. A good mark can identify the project, package number, destination reference, gross weight, handling direction, and sometimes the related tank or accessory group. Labels should remain readable during loading, ocean shipment, unloading, and temporary storage.

Buyers should ask whether small accessory packages are marked clearly enough for site teams. Missing or unclear marks on bolts, sealants, nozzle parts, or platform components can create delays even when the main tank panels are packed correctly. For supplier review, these details are part of real project support and quality control.

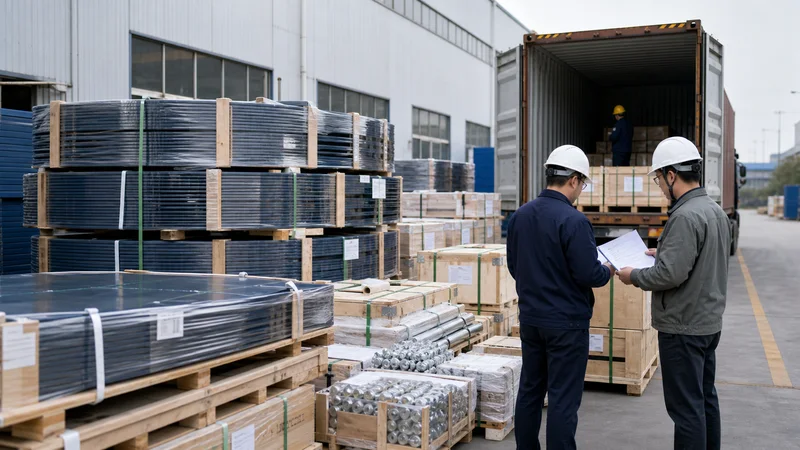

Container loading plan and loading photos

A container loading plan helps the project team understand how materials are arranged before shipment. It can show which pallets or crates are loaded first, where long items are placed, how heavy items are distributed, and whether fragile coated panels are protected from impact. Loading photos provide additional evidence for packing condition and package sequence.

For coated tank panels, protection during loading is especially important. Panel surfaces, edges, and corners should be protected from direct impact, moisture risk, and unnecessary movement. Loading evidence does not replace inspection, but it gives buyers a better record of what left the factory and how it was loaded.

Receiving checks after container arrival

The receiving team should compare container numbers, package marks, packing list quantities, visible package condition, and any obvious damage before materials are moved to the storage area. If the project site is busy or remote, this check should be planned before the container arrives. Photos taken at unloading can help resolve questions later.

After unloading, materials should be stored so that panel marks, accessory labels, and package numbers remain visible. If packages are opened too early without a sorting plan, small parts may be separated from their records. The industrial tank installation preparation checklist gives broader site-readiness points that connect with this receiving stage.

Documents buyers can request before shipment

  • Final packing list with package numbers, descriptions, quantities, weights, and dimensions
  • Container loading plan or container allocation summary
  • Loading photos for pallets, crates, long items, and accessory packages
  • Shipping marks or package label examples
  • Accessory list matched with nozzles, ladders, platforms, roof parts, bolts, and sealants
  • Any special handling note for coated panels or project-specific components

Connect packing review with product scope

Packing review becomes more useful when buyers know what the product package includes. If the project is still comparing tank types or accessory scope, product-level pages such as the main site overview for GFS tanks can help teams understand what components may be involved. The Center Enamel brand site then supports the company, documentation, packing, and execution review layer.

Practical takeaway

Export packing is part of project execution, not just shipping. A clear packing list, readable shipping marks, container loading record, accessory organization, and receiving checklist help buyers reduce site confusion after containers arrive. When these documents are prepared before shipment, the owner, EPC contractor, local installer, and supplier can work from the same information and move more smoothly into installation.
